Construction Central

Ribbon Cutting of the SEP Middle School building.

Building the Future of Southeast Polk

Southeast Polk is growing rapidly. To keep pace, we are actively building new spaces and maintaining our current facilities. This page is your central hub to track active construction, major renovations, and routine maintenance across the district. Check back monthly for the latest.

Last Updated: June 2026

Bond 2025 Projects

Voters approved a $51 million bond in November 2025 to invest in safe, modern learning environments, with no increase to the district’s tax levy rate. For more details, read the full bond overview.

  • Project Scope: Build, furnish, and equip a new elementary school to manage district-wide enrollment growth.

  • Project Partners: DLR Group (Architect) | Miron Construction (Construction Manager)

  • Target Completion: Fall 2029

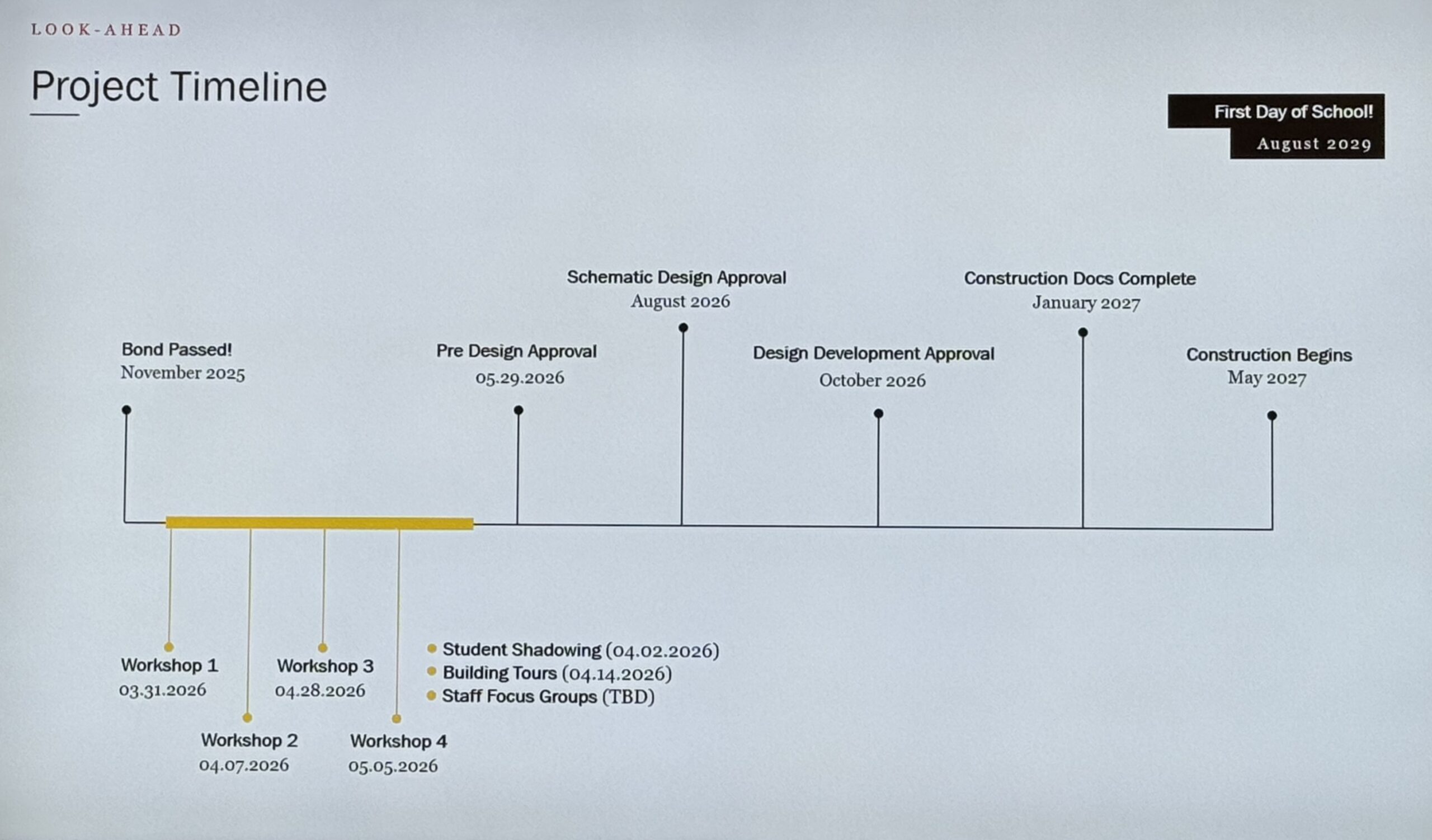

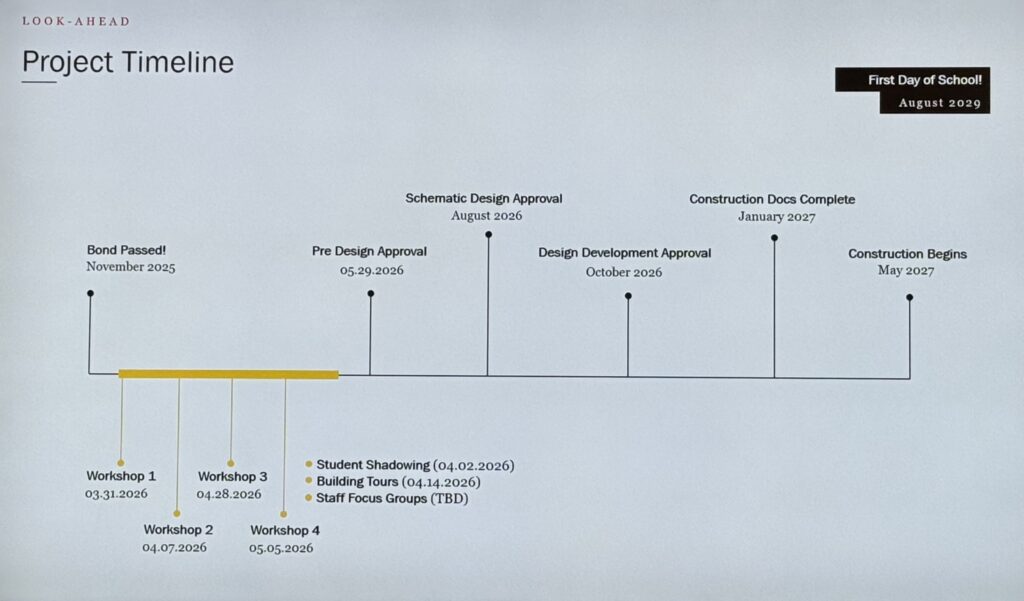

  • Progress Timeline:

    • June 2026: Miron Construction officially approved by the School Board as construction manager. DLR Group completed stakeholder workshops to define modern classroom standards.

    • April 2026: DLR Group selected as project architect; stakeholder committees formed to begin design sessions.

    • November 2025: Voters approved the $51 million bond referendum.

  • Project Scope: Relocate the main office to the building entrance and expand the student commons area.

  • Project Partners: OPN Architects (Architect) | Construction Manager TBD

  • Target Completion: TBD (Updated as construction schedules finalize)
  • Progress Timeline
    • July 2026 (Target): Formal construction manager recommendation goes to the School Board for review and approval.

    • June 2026: The project design team, in collaboration with district and building staff, has developed preliminary designs and layouts
    • April 2026: OPN Architects selected as project architect; formal design team kickoff meeting held

  • Project Scope: Comprehensive safety and accessibility updates across all PK-5 schools.

  • Project Partners: Neumann Monson Architects (Design Partner)

  • Target Completion: Fall 2027 (Ready for the first day of school)

  • Progress Timeline/Milestones

    • June 2026: Site preparedness is underway, with specific needs being identified for each elementary location. Work is focused on a comprehensive district play space plan prioritizing safety, functionality, and accessibility

    • April 2026: Neumann Monson Architects officially selected as the playground design partner.

Facility Improvements

Projects identified through routine facilities inspections and ongoing review of building conditions; lists represent major capital/facility improvements.

  • Project Scope: Construct updated central support facilities for district logistics and maintenance teams

  • Current Status: Active site preparation

  • Progress Milestones:

    • June 2026: Earthwork and site grading underway

    • June 2026: Installation of underground utility infrastructure commenced

  • Project Scope: District-wide safety, infrastructure, and aesthetic refreshes.

  • Target Completion: August 2026 (Prior to the start of the 2026-2027 school year)

  • Progress Milestones:
    • Installation of protective window film at various building entry locations
    • Reconfiguration of instructional space to support the EmPowerU Life Skills program
    • Targeted improvements to walkways, entry areas, railings, and service access points at several elementary buildings and the Junior High
    • Window coverings at the Middle School
    • Renewal of interior paint and flooring in selected areas of district facilities
    • Exterior masonry and sealant repairs at several elementary buildings
    • Drainage and landscaping improvements at Willowbrook Elementary
